Demolishing the affected ceiling under containment during the abatement

Asbestos Abatement · Northwest of Atlanta, GA

Asbestos in a funeral home northwest of Atlanta

What came in as a water leak above the preparation room of this 1970 funeral home turned into a full asbestos abatement once testing confirmed asbestos in the old materials. Here's how we sequenced the work around an active facility and saw it through clearance and drying.

Once the asbestos test came back positive, the water work froze in place: nothing could be removed until the asbestos was abated under containment and cleared by an outside inspector. That turned a straightforward cleanup into weeks of careful sequencing, in a building that kept holding services the whole time.

How the job went

It started with a pinhole leak

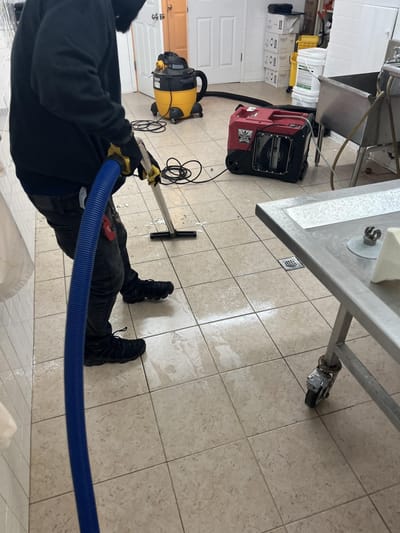

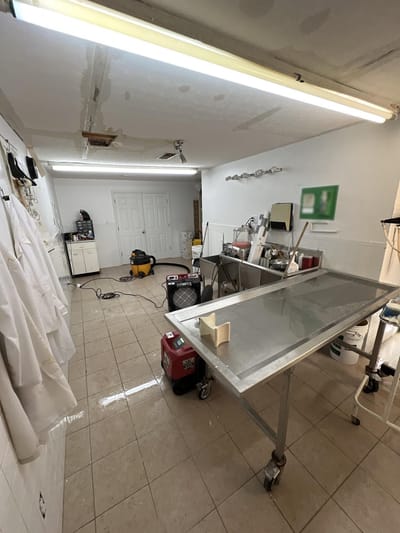

A pinhole leak in a pressurized supply line above the preparation room ceiling had been pushing water through the ceiling, insulation and wall cavities into the room and the bathroom beyond it. The 1970 building meant layered old materials: a double-layer drywall ceiling with paneling behind it, tile walls and a tile floor. We extracted the water and set drying equipment to stabilize the space while we figured out what was actually in the assemblies.

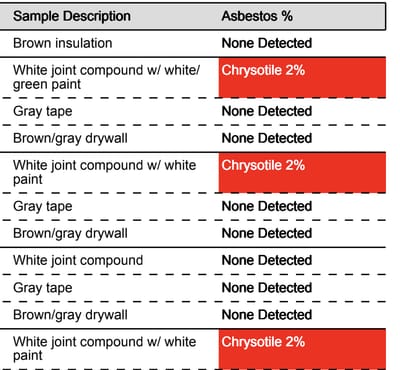

Testing put the brakes on the whole job

In a building this age, nothing gets torn out before it's tested. We pulled samples, and the lab confirmed asbestos in the drywall joint compound and tape, and later in the vinyl flooring and the adhesive under the tile. That stops a water job cold, because you can't remove or even disturb asbestos-containing materials. So the drying couldn't advance. The structure sat saturated, on purpose, while we notified the state and scheduled licensed abatement. Holding a wet building in place is the last thing you want with water, but it's the only safe and legal order to work in.

Working around an active facility

This was a funeral home still holding services, so the schedule had to bend around them. More than once we arrived to start and found the preparation room still in use, and we stayed out and rescheduled rather than push in. Doing this job right meant respecting how the building was being used, even on the days that cost us time.

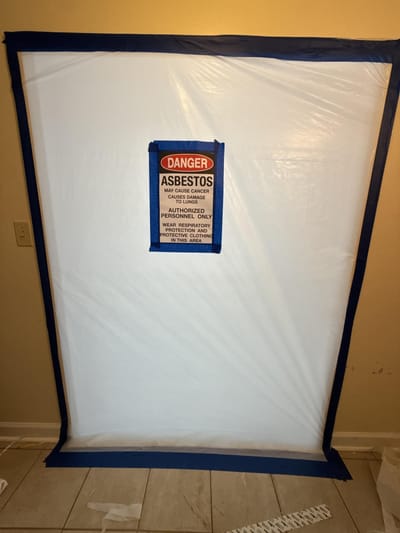

Containment, then regulated removal

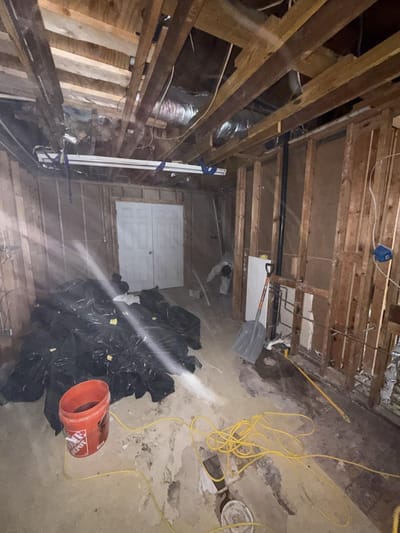

Once the state authorized the work and the room was cleared, we sealed everything off: poly over the doorways and down the hallways, the HVAC vents closed up so nothing traveled through the ducts, and a wrapped dumpster staged for the regulated waste. Then the crew removed the asbestos materials under those controls, the ceiling and wall drywall, the insulation, the tile and trim, all bagged, labeled and hauled as regulated asbestos waste.

The building kept giving up surprises

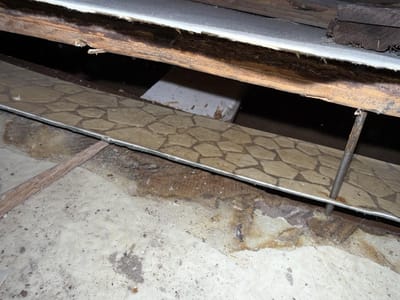

Opening it up uncovered far more than the water and asbestos. There was hidden mold in the ceiling, the wall cavities and the HVAC ductwork. Behind the finishes were layers nobody expected: hardwood paneling on the walls and ceiling, drywall stacked above the sill plates, even an older bathroom built into the assembly. The floor alone ran about six layers deep, ceramic tile, two mortar beds, asbestos vinyl, hardwood, plywood, then more hardwood, with asbestos adhesive bonded to the wood. We also found a second active leak near the water heater from an old welded joint, and shut the water off at the main to stop it adding to the damage. Every find got documented, folded into the scope, and the floor removal was paused and resequenced so the asbestos was handled in the right order.

Cleared by an outside inspector, then finally dried

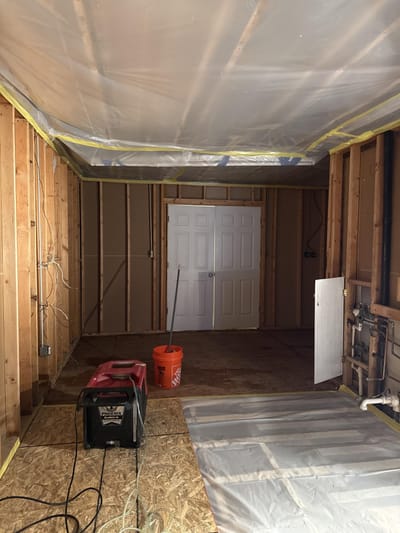

With demolition done and the framing HEPA-vacuumed and wiped down, an independent third-party inspector ran a visual check and air sampling, and the work passed. Only then could we finish what the job started as. The structure was still wet, so the dehumidifiers and an air scrubber stayed on until the sill plates and subfloor came back to a documented dry standard. Then the containment came down, we walked it with the owner, and the building was clean, dry and ready to rebuild.
